FINANCIAL GUIDE Personal Loans

Variable Income and Personal-Loan Payments: Build a Timing Buffer

Map irregular pay against a personal-loan due date, test delayed income, and calculate a cash-timing gap with a practical private worksheet.

An open blank notebook beside pens, a pencil and a ruler.

Estimated reading time: 8 minutes

Variable income loan payments need a calendar as well as a monthly total. Trace when cash becomes usable, identify the lowest balance between receipts and test one expected payment arriving late.

A positive monthly budget doesn’t guarantee that cash will be available on your personal-loan payment date. With variable income, check the lowest projected balance between receipts, then test what happens if an expected payment arrives late.

This guide measures a timing gap using a fictional calendar. It doesn’t calculate how much you qualify to borrow or prescribe a universal savings target. Keep your worksheet privately; no account numbers, tax documents or uploads are needed.

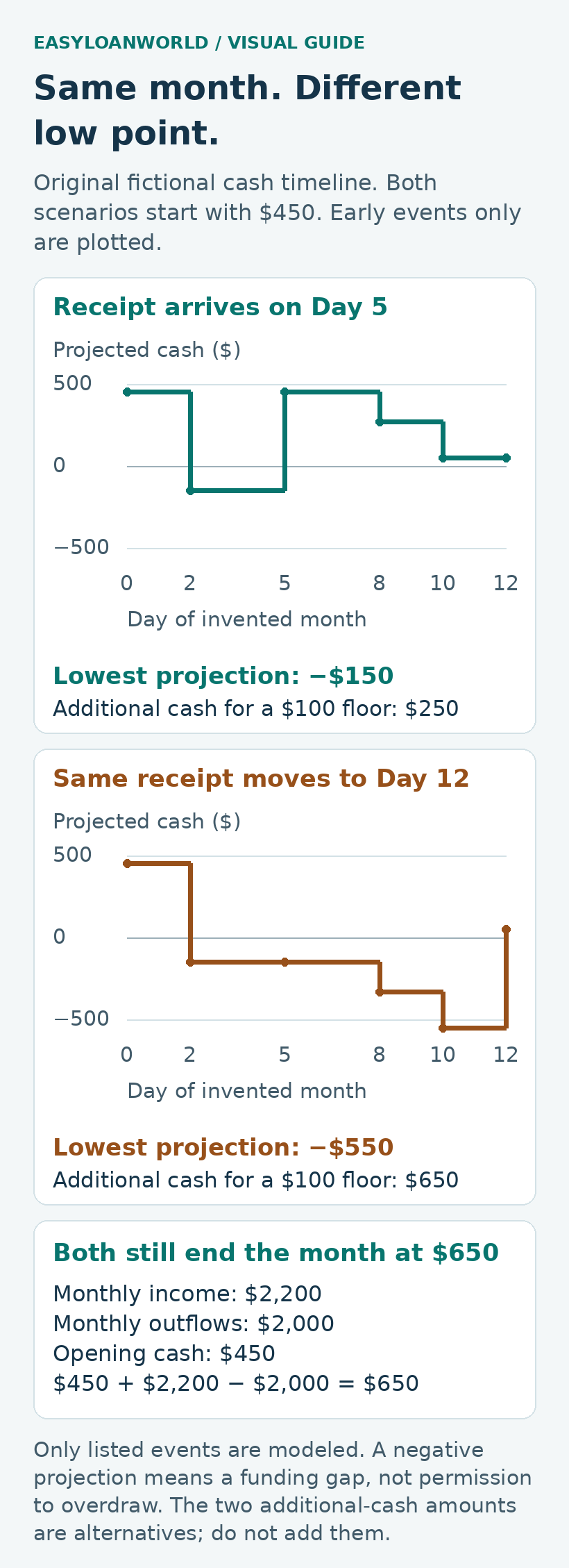

Variable income loan payments: Two step charts compare projected cash when the same receipt arrives on different dates.
Original fictional timeline showing the first 12 days of the article’s month. Both start with $450; only the $600 receipt moves from Day 5 to Day 12. The chosen $100 floor requires $250 or $650 additional opening cash, respectively. These are alternative cushions. Both full-month projections end at $650. Negative projections identify unfunded sequences, not successful overdrafts. No other transactions, fees or deposit interest are modeled. Original diagram: EasyLoanWorld.

Variable income loan payments: find the lowest cash point

The CFPB’s cash-flow budgeting tool tracks when money comes in and goes out, carrying available cash forward. That timing view can reveal a shortage hidden by a positive monthly total.

We use two planning labels:

  • Operating floor: Cash you choose to leave untouched during the projection.
  • Additional timing cushion: Extra opening cash needed, above the opening amount already entered, to keep the projection at that floor.

These are this guide’s labels, not official definitions or lender requirements. An operating floor isn’t a complete emergency plan. Keep money earmarked for other purposes outside available opening cash unless you deliberately change that allocation. Don’t count the same dollars twice.

Use money that’s available, with dates you can defend

Record the cash currently usable after known pending withdrawals and protected earmarks. Note those adjustments so they aren’t deducted again later. An invoice sent isn’t yet spendable cash. Use the amount available for these bills, rather than gross invoice revenue or a hoped-for job.

Give each expected receipt a confidence label: confirmed, estimated or uncertain. Record what supports its expected date. This is a planning distinction, not a statement about which income a lender accepts. Don’t include restricted benefits as money available for a loan payment.

Enter the actual required installment and due date, allowing for the payment-processing instructions you verify with the servicer. Date everyday spending too. If a deposit and withdrawal share a date and their posting order is unknown, test withdrawals first. Even a weekly surplus can conceal a shorter gap.

A $200 monthly surplus can still leave an early shortage

Here’s an invented month with $450 of available opening cash. That figure is already adjusted for pending withdrawals and other earmarks. Only the events listed below are modeled. Income is assumed usable on its stated date; fees, deposit interest and all other transactions are excluded.

  • Day 2: $600 essential bills leave. Projected balance: −$150.
  • Day 5: $600 usable income arrives. Balance: $450.
  • Day 8: $180 required personal-loan payment leaves. Balance: $270.
  • Day 10: $220 essential spending leaves. Balance: $50.
  • Day 17: $1,100 usable income arrives. Balance: $1,150.
  • Day 20: $700 bills and spending leave. Balance: $450.
  • Day 27: $500 usable income arrives. Balance: $950.
  • Day 28: $300 bills and spending leave. Balance: $650.

Monthly income totals $2,200 and outflows total $2,000, leaving a $200 flow surplus. Ending cash is $450 + $200 = $650. The $650 is not all new savings; it includes the opening cash.

Nevertheless, the projection reaches −$150 on Day 2. A negative projection identifies an unfunded sequence. It doesn’t mean the bank will allow an overdraft or that a payment will succeed. Resolve the shortage before relying on that payment plan.

Suppose this fictional household independently chooses a $100 operating floor. It needs $100 − (−$150) = $250 in additional opening cash. Its total opening amount would become $700. Every projected balance would rise by $250, making the lowest $100.

That extra cash bridges only the modeled timing gap. It doesn’t establish long-term affordability or cover unknown expenses.

Variable income loan payments: delay one receipt

Now move the same $600 receipt from Day 5 to Day 12. Leave every other amount and date unchanged. Starting again with $450, the early balances become:

  • Day 2, after essential bills: −$150.
  • Day 8, after the loan payment: −$330.
  • Day 10, after essential spending: −$550.
  • Day 12, after the delayed receipt: $50.

From Day 17 onward, the original balances resume. Monthly income remains $2,200, outflows remain $2,000, and ending cash remains $650. Yet the lowest projection has fallen to −$550.

Preserving the same $100 floor now requires $650 in additional opening cash: $100 − (−$550). Total opening cash would be $1,100. The delayed case needs $400 more cushion than the first case.

The $250 and $650 cushions are alternatives; don’t add them together. The delayed receipt is still $600. The $400 measures the difference between the two scenarios’ lowest balances.

Calculate the cushion without counting opening cash twice

Additional cash needed = the larger of zero or: chosen floor minus lowest projected balance.

The lowest balance must already include your opening cash. If the projection never falls below your chosen floor, this calculation gives zero additional timing cash. That result isn’t a guarantee against unmodeled costs or delays.

If the required cushion isn’t available, writing the number down doesn’t fund it. Identify a real change before the short date: a genuinely flexible expense, an earlier verified receipt or an approved change to payment timing.

The CFPB’s cash-flow adjustment tool suggests discussing due-date changes with creditors. Ask your servicer whether a change is available and when it would take effect.

Confirm what remains due while the request is pending. Ask whether a transition changes interest, the next installment or the debit date. These are questions to resolve, not promised features. A timing adjustment doesn’t create income or repair a recurring deficit.

Test the early variable income loan payments bottleneck

The limited calendar below can isolate the first twelve days. It accepts only two deposits and four spending events, so it can’t reproduce every event in the full-month example. Use a 30-day form, but interpret this exercise only through Day 12; later receipts and bills are deliberately omitted. Its ending balance isn’t the article’s complete-month $650 result.

Entries for the early-window timing check
Field Amount and day
Opening cash and month length $450; 30 days
First deposit $600 on Day 5
Second deposit $0 on Day 1
Housing category $600 on Day 2
Utilities and insurance category $220 on Day 10
Debt payment $180 on Day 8
Other spending $0 on Day 1

The category labels organize these fictional entries; they don’t reclassify the original bills. Keep the zero-dollar entries and their valid days so old example defaults don’t add unintended flows.

The lowest modeled balance should be minus $150. The tool reports $150 additional opening cash to avoid a negative end-of-day balance. The article’s chosen $100 floor requires another $100 above that zero threshold, making the previously calculated $250 cushion. Don’t add opening cash again: the low point already includes the entered $450.

Move only the first deposit to Day 12. The low point becomes minus $550, and the tool’s additional cash to reach zero becomes $550. Preserving the separate $100 floor requires $650. These are alternative scenarios; the delay doesn’t create a second $600 receipt.

For actual variable income loan payments, return to a complete dated ledger after this isolated check. The form nets same-day events and can’t prove within-day availability. Confirm usable deposit dates and required payment timing; changing the calculator doesn’t change a contractual due date.

Copy this private timing worksheet

  1. Horizon: Start and end dates; which major bill cycle and expected receipts does it cover?
  2. Opening cash: Usable amount; pending withdrawals already deducted; other earmarks excluded.
  3. Events: Date, receipt or outflow, amount, confidence, supporting evidence and projected balance after each event.
  4. Lowest point: Amount and date, before adding any new cushion.
  5. Floor: Chosen amount and reason; additional timing cash calculated.
  6. Delay test: Receipt moved, revised date, new lowest point and alternative cushion.
  7. Adjustment: Proposed change, whose agreement it needs, confirmed effective date and obligations until then.
  8. Checkpoint: Actual receipt received, upcoming obligations reserved and projection updated.

Extend the horizon through the next relevant bills and receipts, including a known slow season. Month-end isn’t a natural stopping point if the following week’s bills depend on that closing cash.

After each receipt, replace the estimate with the actual usable amount and recalculate before optional spending or extra loan payments. A high balance today may already be committed. If the cushion is repeatedly consumed without rebuilding, investigate an ongoing income-and-spending gap rather than automatically adding debt. If an installment may be missed, contact the verified servicer about the options for your account; don’t assume relief or suspend required payments.

U.S. consumer education. Examples and planning labels are original illustrations. Sources checked October 19, 2026.

If an installment is already missed, reconcile the lender’s dated catch-up amount separately from the cash buffer for future bills.
